A managed property's asphalt is straightforward. The challenge is a decision that requires board approval, a reserve fund line and residents who need somewhere to park when the crew arrives.
Board-ready quotes
A single number cannot be approved. Boards must show owners what was purchased, so scope needs breaking into surface work, drainage, markings and optional items, each with its own line and price.
Timing shapes the decision as much as scope does. Reserve funds are planned years in advance, and unexpected work competes with other priorities. A quote that identifies which items could defer a season is more useful than one that treats everything as urgent.
Documentation matters for the next board. Condition recorded, photographs taken, work logged at each phase so the incoming board can see what was done and understand why. A sequenced plan handles this across years, annual maintenance tracks it season to season, and the repair or replace decision is where most boards start.
How approval runs
The whole site is walked and recorded, including visitor areas and the service route, because those are the parts that get left out of a scope written from memory.
Items are split into what is failing now and what has a season or two left, which is the split a board needs in order to approve part of a project.

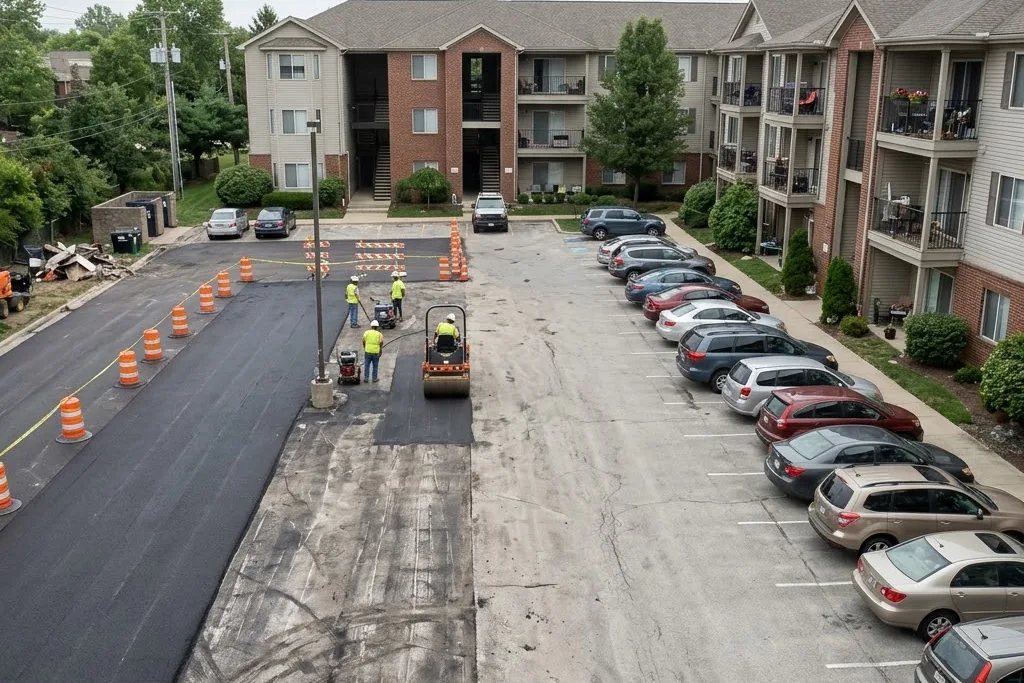

Work is sequenced building by building with a relocation plan for each phase, so nobody is told to move a car on the morning it happens.
Each phase is recorded with photographs and notes, which is what makes the spend defensible at the next owners meeting.
Resident logistics

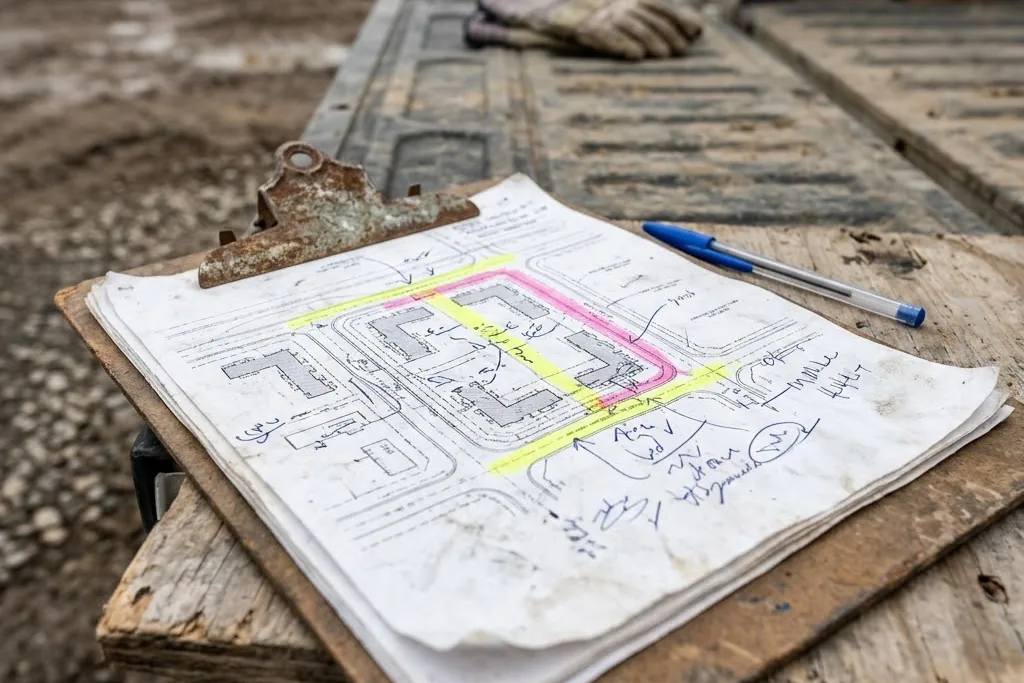

Residents cannot be displaced without a plan. Each phase is drawn with a relocation destination, and notice goes out with enough lead time for people to arrange their parking rather than discover it on the morning work starts.
Accessible spaces and the garbage route are the two items that cause problems when overlooked. Both need a working alternative during every phase, not just most of them.
Visitor bays are usually done last because they absorb displacement while resident rows are closed. Accessible spaces are verified against requirements while lines are off, drainage issues are addressed in the same closure, and the surface work becomes the straightforward part.
Related work
Scoped as separate lines so part of it can be approved.
A ranked list of what the property needs and when, spread across budget years instead of landing in one.
Learn moreAnnual inspection with crack work as it appears, which is the item that keeps the larger spend further away.
Learn moreCounts and dimensions checked against the requirement, which on a managed property is a question somebody will eventually ask.
Learn moreThe decision a board usually wants settled before it will approve anything at all.
Learn moreCommon questions
Condo lot with 80 stalls repaved in three phases so every owner kept a place to park. The board got a notice schedule two weeks ahead.
They dealt with the resident questions directly instead of sending them to the property manager. Fewer emails for me.
Quote came as a per-phase breakdown the board could vote on. Approved first meeting.
Line marking was done the day after sealing so the lot was back to normal by the weekend.
From the blog
Next step
We will survey the site, photograph its condition, and write the scope as separate lines with the deferrable items marked so part of it can be approved.
We will draft the resident notice for each phase if that is useful.
